industrial manufacturing - SURRETTE BATTERY DTO USE CASE

Surrette Battery's Digital Twin journey integrates ERP and shop-floor data for precision in battery production.

Surrette Battery Company Limited is a Canadian industrial manufacturer specializing in deep-cycle batteries for renewable energy storage, rail, and material handling applications. Operating a complex production environment with multiple work centres and both automated and semi-automated processes, Surrette sought to improve operational visibility and decision-making at its main production facility. Like many industrial manufacturers, Surrette faced challenges with:

  • limited visibility into detailed work centre activities and process flows
  • inconsistent labour standards and unclear resource utilization
  • data quality issues across ERP and manual data collection processes
  • difficulty quantifying the impact of process improvements before implementation

These constraints created a need for a more integrated, data-driven planning capability.


Key Problem Statement

Surrette lacked a unified model to:

  • accurately represent production resource requirements (labour, equipment, facility)
  • quantify resource utilization and identify inefficiencies as optimization targets
  • evaluate process improvement opportunities with confidence


CBP-DTO Solution Approach

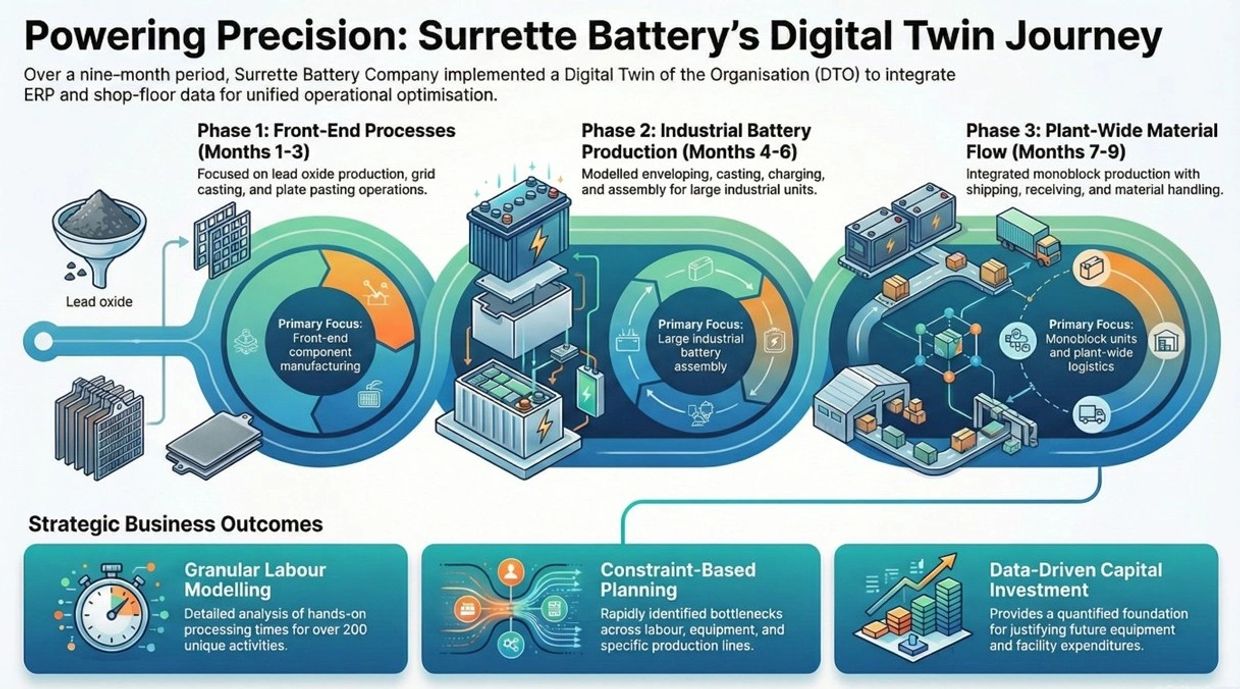

Surrette implemented a Digital Twin of the Organization (DTO) using Collaborative Business Planning (CBP), supported by the QualiWare platform, in a phased modeling approach:

  • Phase 1: Front-end processes (lead oxide production, grid casting, plate pasting)
  • Phase 2: Large industrial battery production (enveloping, casting, charging, assembly)
  • Phase 3: Smaller monoblock battery production (Dynamac, waterbath) and plant-wide material handling, shipping and receiving

Data Integration included ERP (Syspro), Excel-based resource plans, and shop-floor interview, logs and observations.



Key Capabilities Enabled by CBP

Built across three phases over ~9 months and co-funded by NGen, the Surrette DTO modeled a complex industrial manufacturing environment from raw materials to finished product. Capabilities included:

  • End-to-End Operational Visibility
    Single integrated model of production, support activities, and operational flows
  • Granular Labour and Resource Modeling

         Detailed analysis of hands-on processing times for over 200 unique process activities

  • Data Quality Validation

         Reconciliation of modeling flows (demands > processes > resources) with ERP data

  • Constraint-Based Planning
    Identification of bottlenecks across labour, equipment, and production lines
  • Scenario Simulation
    Evaluation of CI initiatives, staffing changes, and production adjustments before execution


Quantified Business Benefits

The DTO replaced estimation and intuition with quantified, data-driven insight — giving Surrette’s leadership the operational clarity and financial evidence to plan with confidence. Benefits included:

   Operational Efficiency

  • Improved visibility into work centre performance
  • Identification of resource constraints and inefficiencies

   Decision Quality

  • Complete understanding of the labour requirements for each battery type produced
  • Data-driven justification of future capital investments

   Continuous Improvement Enablement

  • Structured platform to evaluate and prioritize process improvement initiatives
  • Improved visibility into non-value-added activities


Implementation Timeline: ~ 9 months to full facility DTO

Surrette’s DTO implementation project was funded by NGen, Canada’s lead for Advanced Manufacturing. It was also a key component of a co-funded Engineering Co-op Student Program. In this approach, each phase of the project coincided with a 4-month student work term. The project was led by the Plant Manager and the ERP Manager with coaching assistance from an external CBP-certified partner consultant.


  • Phase 1: Front-end process (3 months)
  • Phase 2: Industrial batteries process (3 months)
  • Phase 3: Monoblock battery processes & material handling (3 months)

Download the Surrette Battery DTO Use Case

Surrette Battery DTO (pdf)Download
